Overhead lines in neighbourhoods and allotments disappearing
99 percent of our power lines are already underground. This enhances the appearance in the neighbourhoods and all over Berlin and protects our network from weather influences. We will also be laying the remaining overhead lines underground in the coming years. Most of these overhead lines are located in allotments or detached home settlements.
By laying the cables in the ground, we are also renewing our electricity grid and thus increasing the power supply security in your neighbourhood.

Here, you can see whether and when your area will be converted, how long the conversion will take and what steps will be taken.
You will find frequently asked questions and their answers at the bottom of the page. Likewise a contact to us.
Current overhead line areas

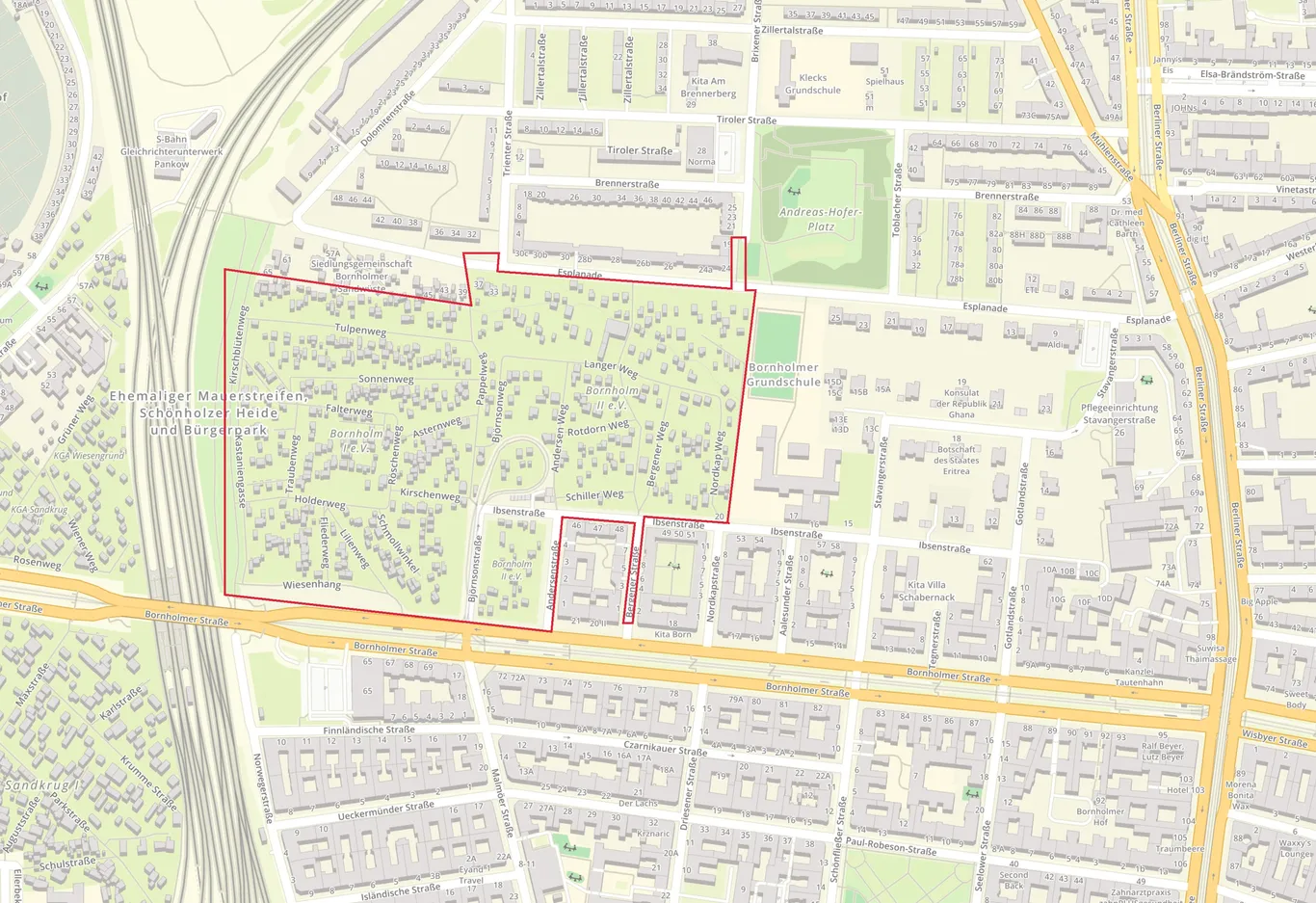

KGA Bornholm I & II in 10439 Berlin-Pankow

- Inspection from June 2023 to September 2023
The current status of the mains connection will be checked and documented. - Civil engineering & grid cable laying from September 2023 to May 2024
Cable trenches will be created, power cables laid and cable distribution cabinets installed. The surface of the ground will be restored (if necessary temporarily). Temporary restrictions will apply. - House connection renovation from June 2024 to June 2025
One of the three variants will apply for you:
A) The mains connections will be reconnected from the overhead line to the new underground cable network.
B) Old grid connections will be replaced with new grid connections.
C) New grid connections will be provided for overhead line connections.
A company commissioned by us will make an appointment with you for installation. Restrictions will apply at certain times. - Shutdown of overhead line network approx. September 2025
End of supply via overhead line. - Dismantling of overhead line network from September 2025 to March 2026
Dismantling of overhead line and masts. Different measures may apply if public lighting is present on the overhead line/masts.
.

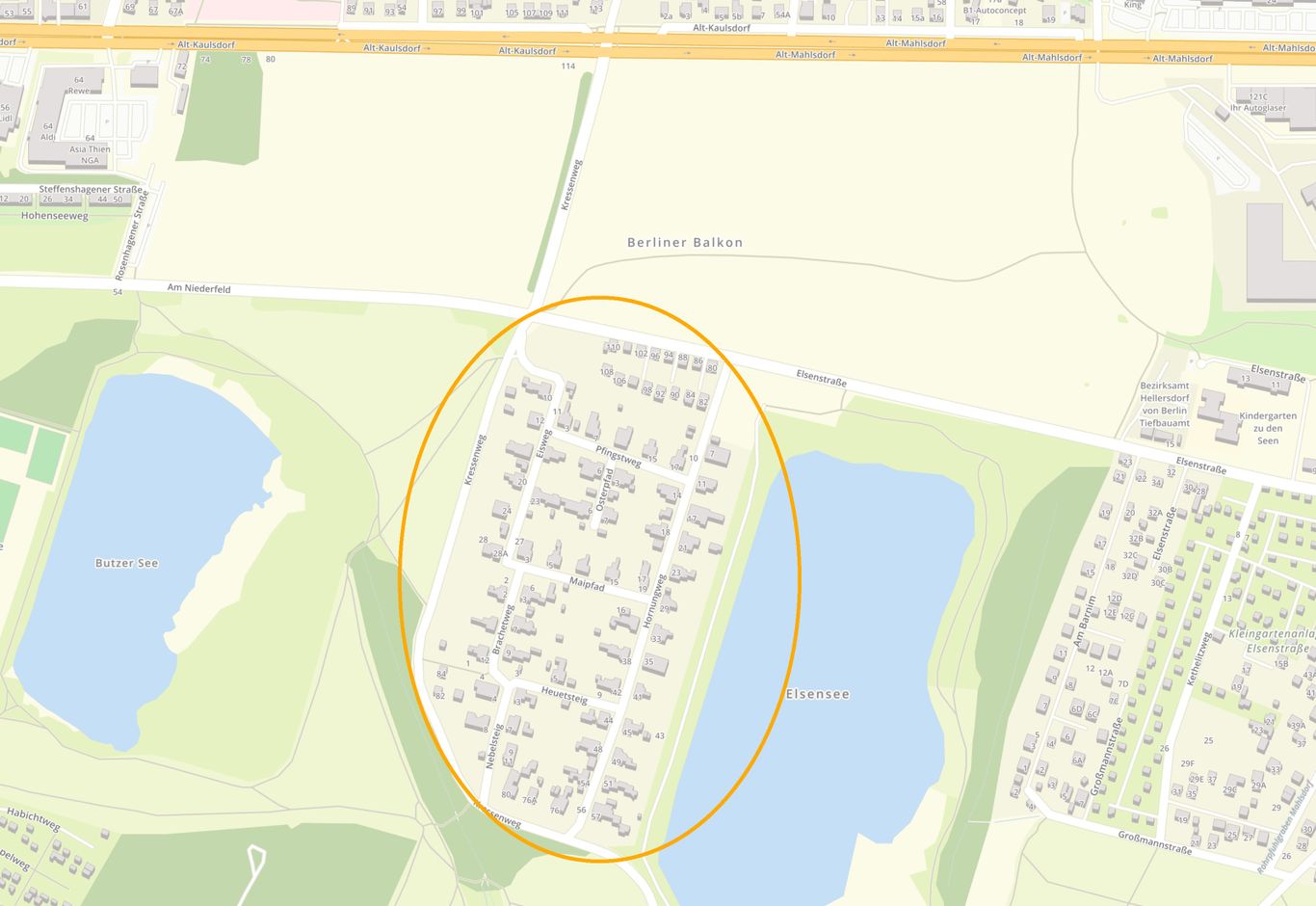

Elsenstraße in 12623 Berlin-Mahlsdorf

- Inspection till August 2023
The current status of the mains connection will be checked and documented. - Civil engineering & grid cable laying from August 2023 to May 2024
Cable trenches will be created, power cables laid and cable distribution cabinets installed. The surface of the ground will be restored (if necessary temporarily). Temporary restrictions will apply. - House connection renovation from Augsut 2023 to June 2024
One of the three variants will apply for you:
A) The mains connections will be reconnected from the overhead line to the new underground cable network.
B) Old grid connections will be replaced with new grid connections.
C) New grid connections will be provided for overhead line connections.
A company commissioned by us will make an appointment with you for installation. Restrictions will apply at certain times. - Shutdown of overhead line network approx. Oktober 2024
End of supply via overhead line. - Dismantling of overhead line network from Oktober 2024 to March 2025
Dismantling of overhead line and masts. Different measures may apply if public lighting is present on the overhead line/masts.

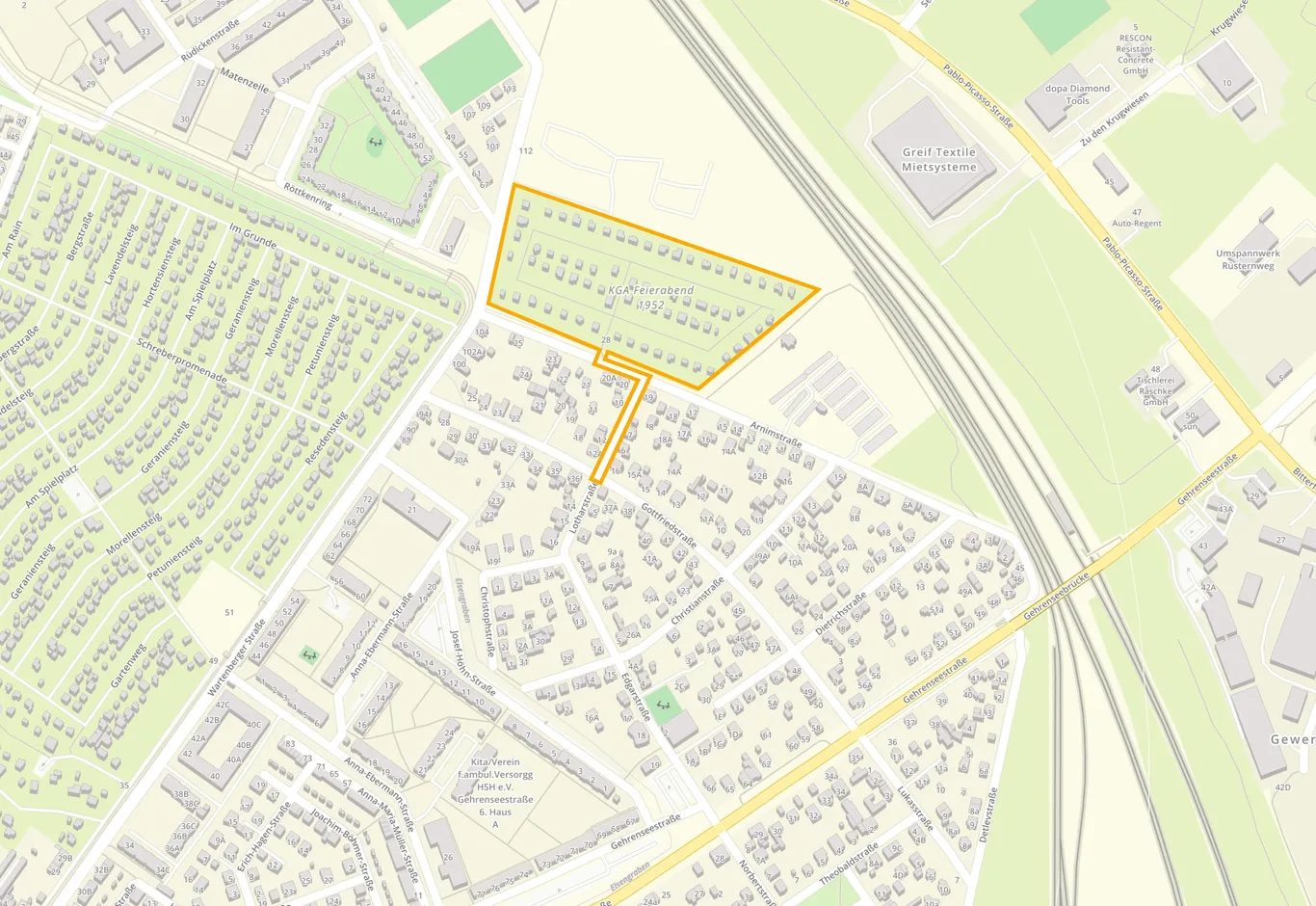

KGA Feierabend in 13053 Berlin-Hohenschönhausen

- Inspection done
The current status of the mains connection will be checked and documented. - Civil engineering & grid cable laying done
Cable trenches will be created, power cables laid and cable distribution cabinets installed. The surface of the ground will be restored (if necessary temporarily). Temporary restrictions will apply. - House connection renovation from August 2023 to September 2023
One of the three variants will apply for you:
A) The mains connections will be reconnected from the overhead line to the new underground cable network.
B) Old grid connections will be replaced with new grid connections.
C) New grid connections will be provided for overhead line connections.
A company commissioned by us will make an appointment with you for installation. Restrictions will apply at certain times. - Shutdown of overhead line network approx. December 2023
End of supply via overhead line. - Dismantling of overhead line network from February 2024
Dismantling of overhead line and masts. Different measures may apply if public lighting is present on the overhead line/masts.

KGA Gartenvörde in 13127 Berlin-Französisch-Buchholz

- Inspection from January 2019 to June 2020
The current status of the mains connection will be checked and documented. - Civil engineering & grid cable laying from November 2023 to January 2024
Cable trenches will be created, power cables laid and cable distribution cabinets installed. The surface of the ground will be restored (if necessary temporarily). Temporary restrictions will apply. - House connection renovation from January 2024 to October 2025
One of the three variants will apply for you:
A) The mains connections will be reconnected from the overhead line to the new underground cable network.
B) Old grid connections will be replaced with new grid connections.
C) New grid connections will be provided for overhead line connections.
A company commissioned by us will make an appointment with you for installation. Restrictions will apply at certain times. - Shutdown of overhead line network approx. October 2025
End of supply via overhead line. - Dismantling of overhead line network from October 2025 to Dezember 2025
Dismantling of overhead line and masts. Different measures may apply if public lighting is present on the overhead line/masts.

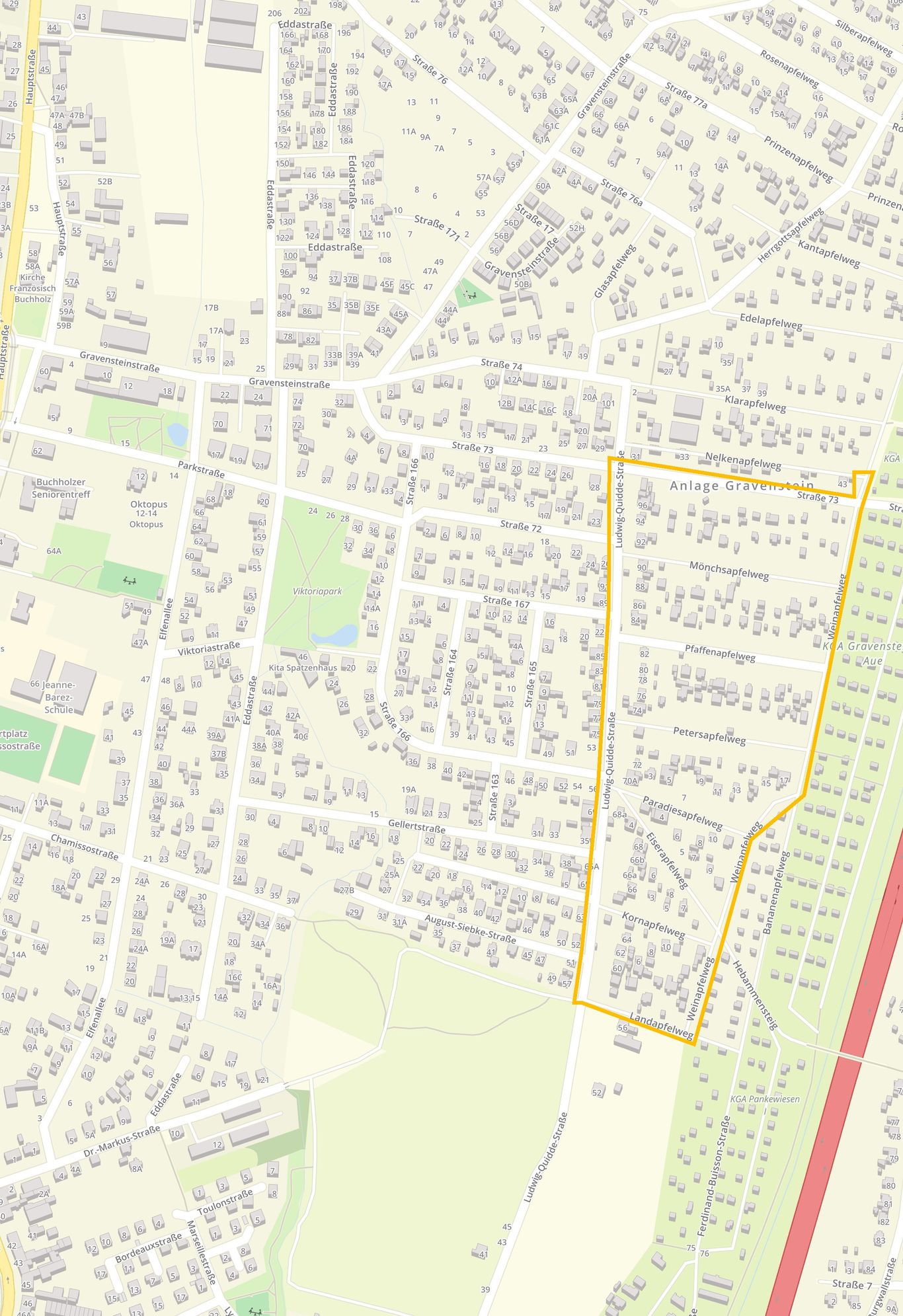

Erholungsanlage Gravenstein in 13127 Berlin-Französisch-Buchholz

- Inspection from January 2019 to June 2020
The current status of the mains connection will be checked and documented. - Civil engineering & grid cable laying from January 2023 to March 2023
Cable trenches will be created, power cables laid and cable distribution cabinets installed. The surface of the ground will be restored (if necessary temporarily). Temporary restrictions will apply. - House connection renovation from April 2023 to October 2024
One of the three variants will apply for you:
A) The mains connections will be reconnected from the overhead line to the new underground cable network.
B) Old grid connections will be replaced with new grid connections.
C) New grid connections will be provided for overhead line connections.
A company commissioned by us will make an appointment with you for installation. Restrictions will apply at certain times. - Shutdown of overhead line network approx. October 2024
End of supply via overhead line. - Dismantling of overhead line network from October 2024 to December 2024
Dismantling of overhead line and masts. Different measures may apply if public lighting is present on the overhead line/masts.

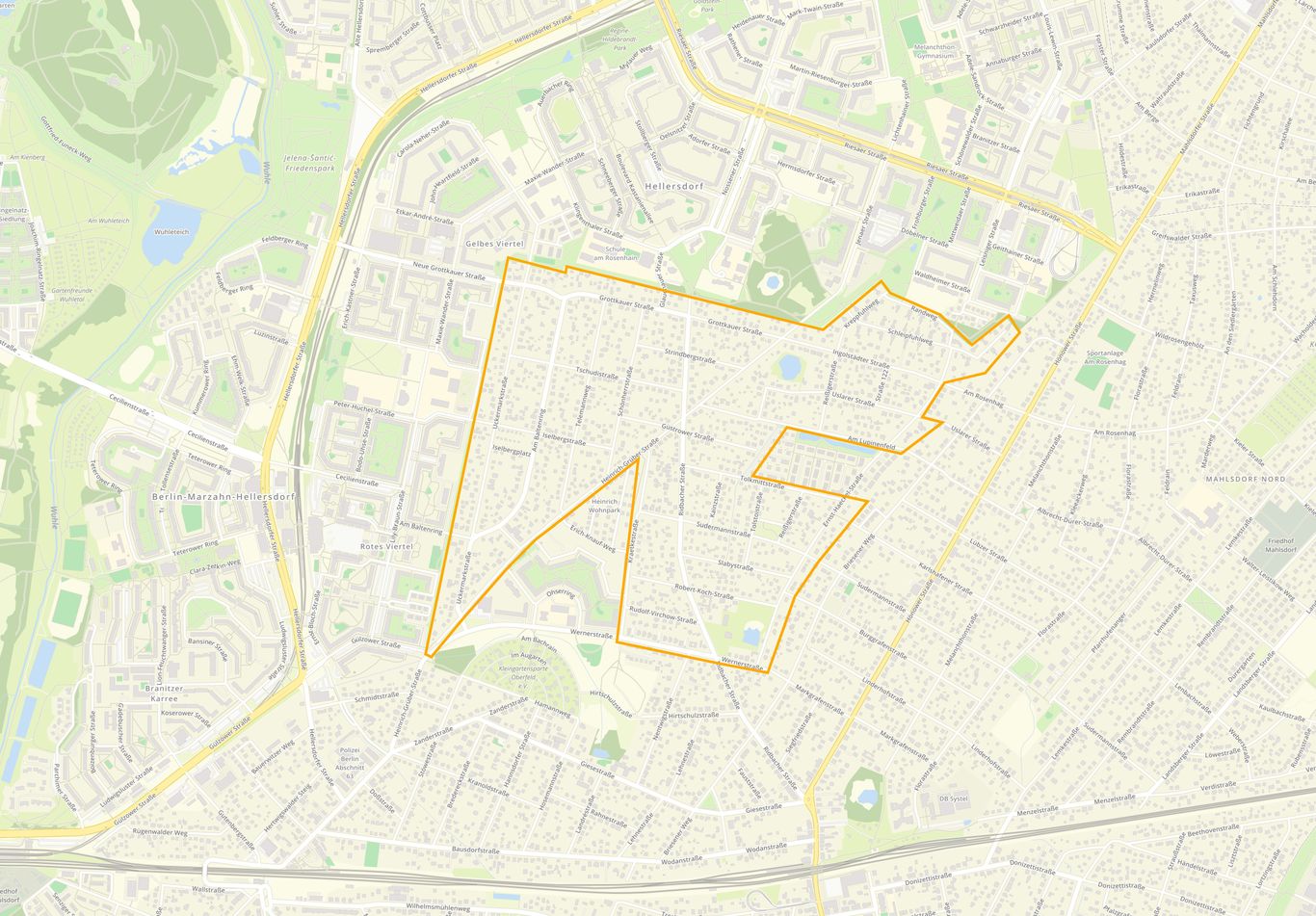

Heinrich-Grüber-Straße in 12621 Berlin-Kaulsdorf

- Inspection from March 2023 to Juli 2023
The current status of the mains connection will be checked and documented. - Civil engineering & grid cable laying from November 2023 to January 2025
Cable trenches will be created, power cables laid and cable distribution cabinets installed. The surface of the ground will be restored (if necessary temporarily). Temporary restrictions will apply. - House connection renovation from December 2023 to May 2025
One of the three variants will apply for you:
A) The mains connections will be reconnected from the overhead line to the new underground cable network.
B) Old grid connections will be replaced with new grid connections.
C) New grid connections will be provided for overhead line connections.
A company commissioned by us will make an appointment with you for installation. Restrictions will apply at certain times. - Shutdown of overhead line network approx. September 2025
End of supply via overhead line. - Dismantling of overhead line network from September 2025 to March 2026
Dismantling of overhead line and masts. Different measures may apply if public lighting is present on the overhead line/masts.

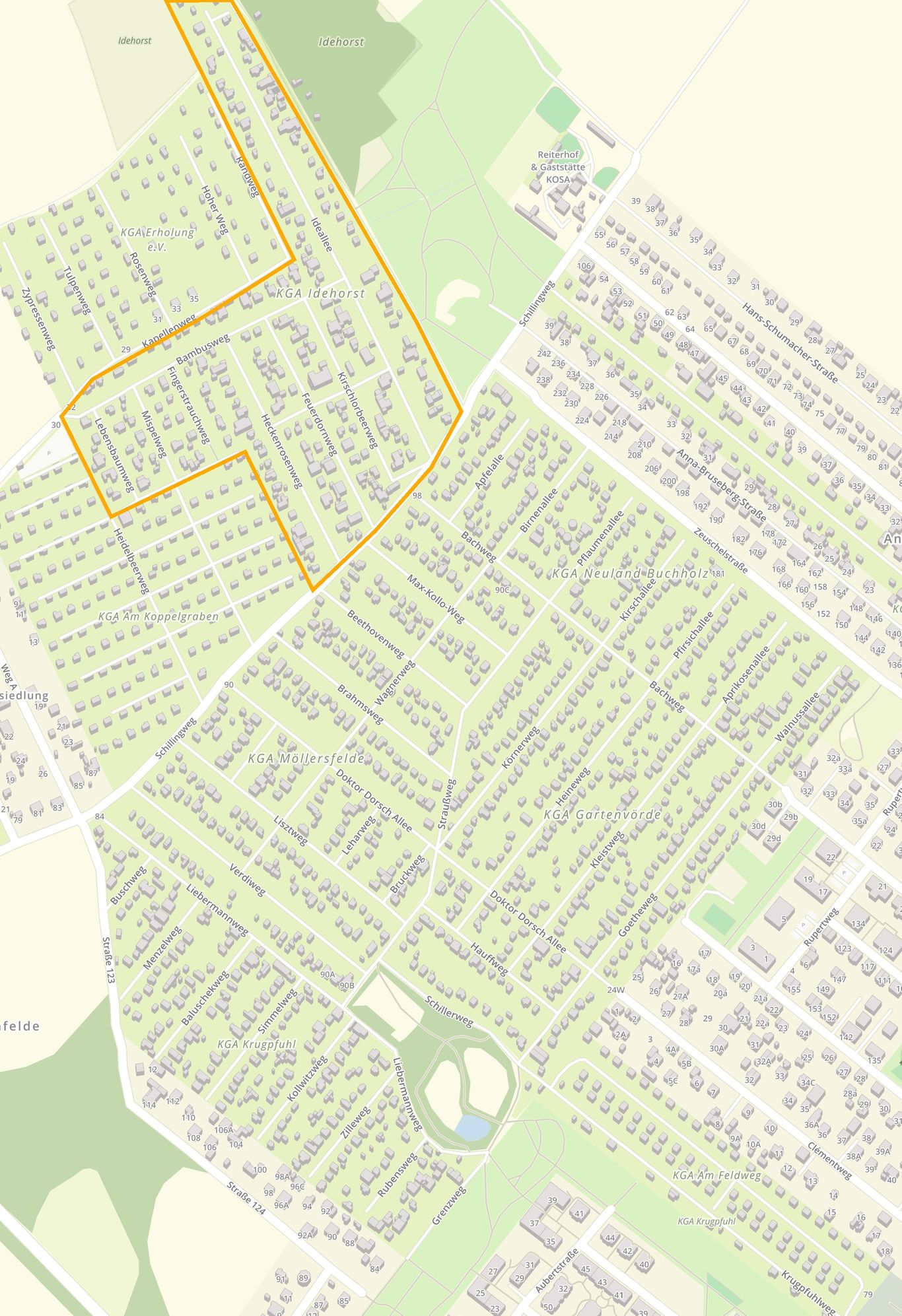

Erholungsanlage Idehorst in 13159 Berlin-Blankenfelde

- Inspection from January 2019 to June 2020
The current status of the mains connection will be checked and documented. - Civil engineering & grid cable laying from April 2023 to December 2023
Cable trenches will be created, power cables laid and cable distribution cabinets installed. The surface of the ground will be restored (if necessary temporarily). Temporary restrictions will apply. - House connection renovation from August 2023 to October 2025
One of the three variants will apply for you:
A) The mains connections will be reconnected from the overhead line to the new underground cable network.
B) Old grid connections will be replaced with new grid connections.
C) New grid connections will be provided for overhead line connections.
A company commissioned by us will make an appointment with you for installation. Restrictions will apply at certain times. - Shutdown of overhead line network approx. October 2025
End of supply via overhead line. - Dismantling of overhead line network from October 2025 to December 2025
Dismantling of overhead line and masts. Different measures may apply if public lighting is present on the overhead line/masts.

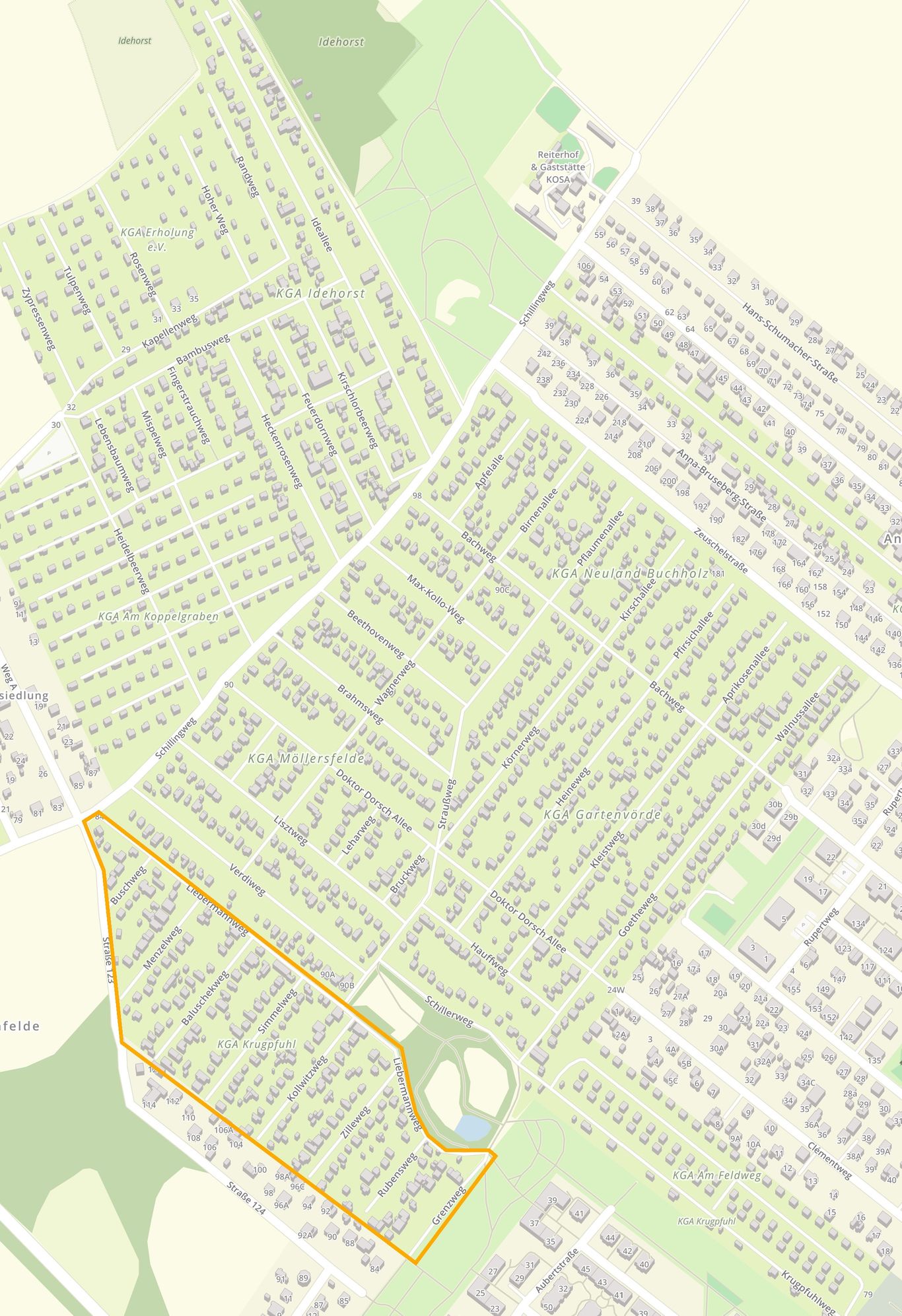

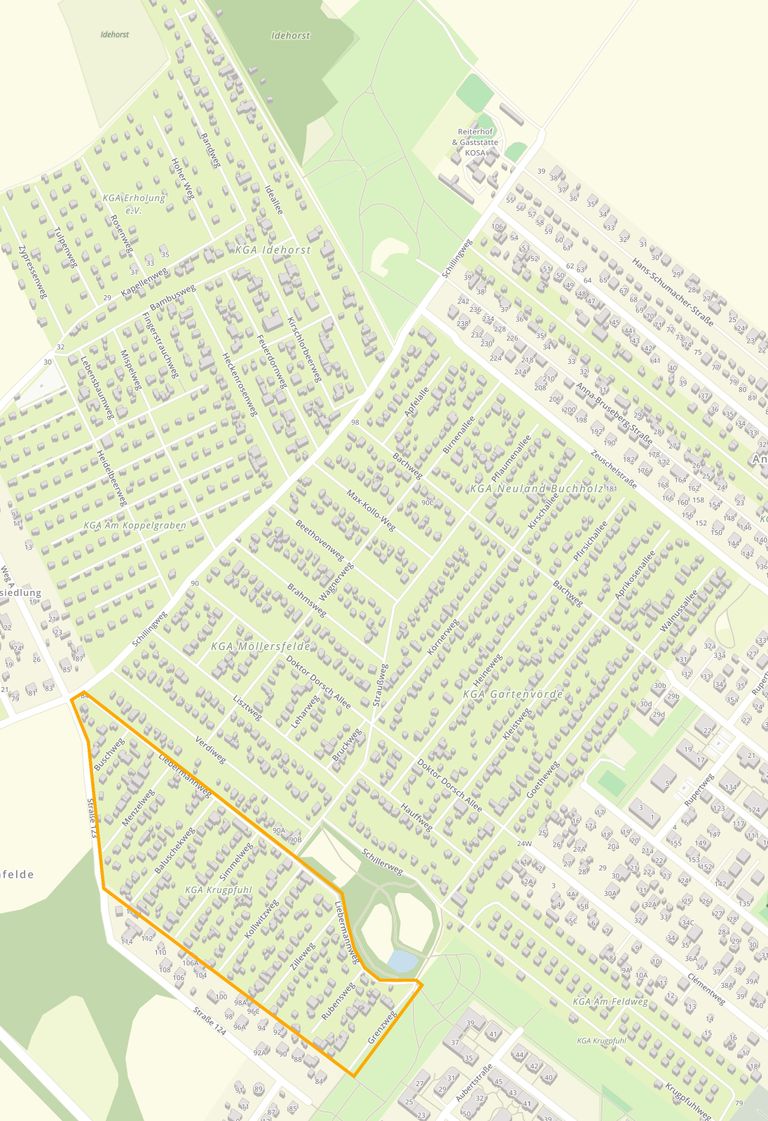

KGA Krugpfuhl in 13127 in Berlin-Französisch-Buchholz

- Inspection from January 2019 to June 2020
The current status of the mains connection will be checked and documented. - Civil engineering & grid cable laying from January 2024 to April 2024
Cable trenches will be created, power cables laid and cable distribution cabinets installed. The surface of the ground will be restored (if necessary temporarily). Temporary restrictions will apply. - House connection renovation from March 2023 to October 2025
One of the three variants will apply for you:
A) The mains connections will be reconnected from the overhead line to the new underground cable network.
B) Old grid connections will be replaced with new grid connections.
C) New grid connections will be provided for overhead line connections.
A company commissioned by us will make an appointment with you for installation. Restrictions will apply at certain times. - Shutdown of overhead line network approx. October 2025
End of supply via overhead line. - Dismantling of overhead line network from October 2025 to December 2025
Dismantling of overhead line and masts. Different measures may apply if public lighting is present on the overhead line/masts.
KGA Neuland Buchholz in 13127 Berlin-Französisch-Buchholz

- Inspection from January 2019 to Junie 2020
The current status of the mains connection will be checked and documented. - Civil engineering & grid cable laying from September 2023 to November 2023
Cable trenches will be created, power cables laid and cable distribution cabinets installed. The surface of the ground will be restored (if necessary temporarily). Temporary restrictions will apply. - House connection renovation from November 2023 to Oktober 2025
One of the three variants will apply for you:
A) The mains connections will be reconnected from the overhead line to the new underground cable network.
B) Old grid connections will be replaced with new grid connections.
C) New grid connections will be provided for overhead line connections.
A company commissioned by us will make an appointment with you for installation. Restrictions will apply at certain times. - Shutdown of overhead line network approx. October 2025
End of supply via overhead line. - Dismantling of overhead line network from October 2025 to December 2025
Dismantling of overhead line and masts. Different measures may apply if public lighting is present on the overhead line/masts.

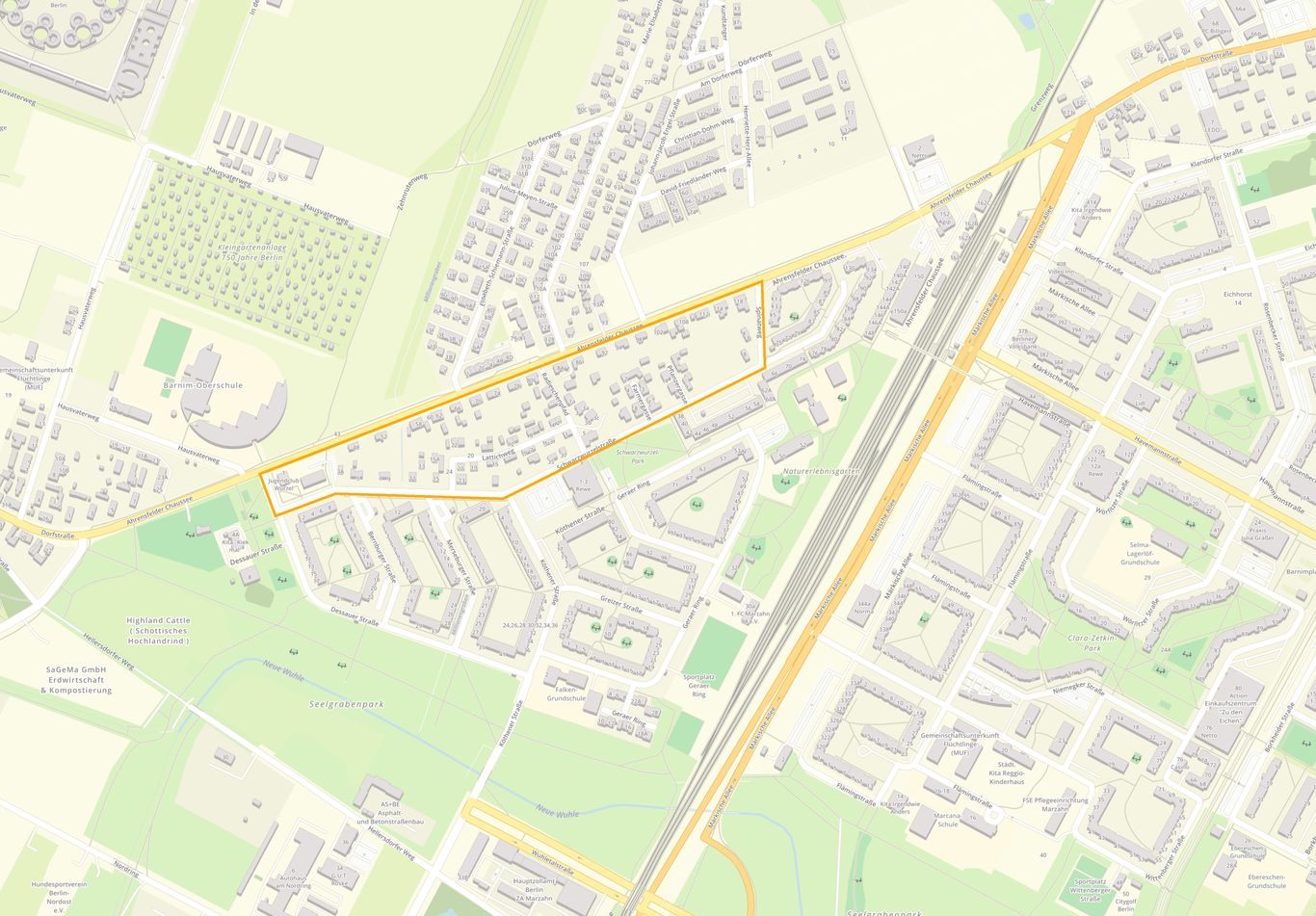

Schwarzwurzelstraße in 12689 Berlin-Marzahn

- Inspection from March 2023 to July 2023
The current status of the mains connection will be checked and documented. - Civil engineering & grid cable laying from August 2023 to May 2024
Cable trenches will be created, power cables laid and cable distribution cabinets installed. The surface of the ground will be restored (if necessary temporarily). Temporary restrictions will apply. - House connection renovation from August 2023 to July 2024
One of the three variants will apply for you:
A) The mains connections will be reconnected from the overhead line to the new underground cable network.
B) Old grid connections will be replaced with new grid connections.
C) New grid connections will be provided for overhead line connections.
A company commissioned by us will make an appointment with you for installation. Restrictions will apply at certain times. - Shutdown of overhead line network approx. December 2024
End of supply via overhead line. - Dismantling of overhead line network from January 2025 to March 2025
Dismantling of overhead line and masts. Different measures may apply if public lighting is present on the overhead line/masts.

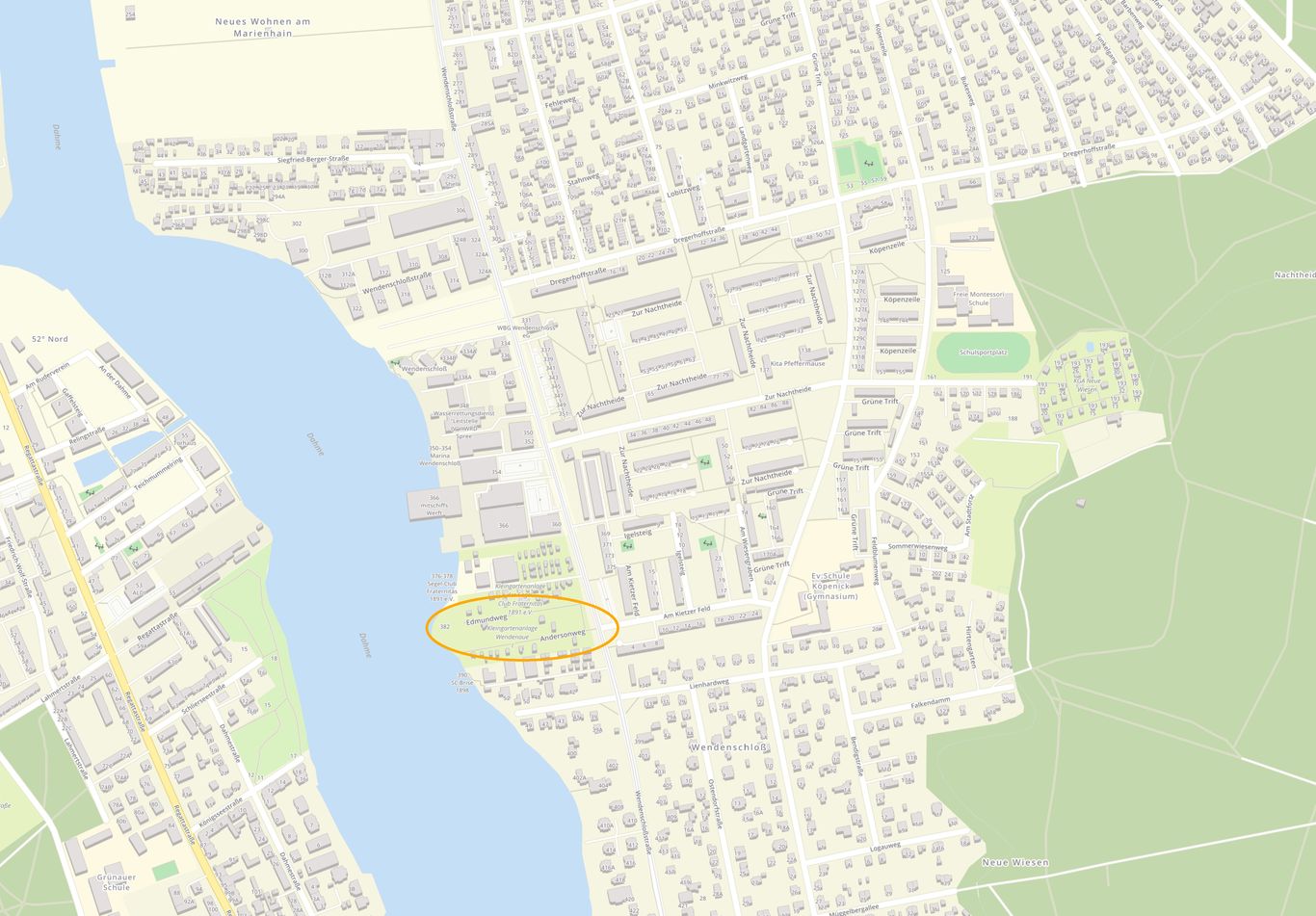

KGA Wendenaue in 12557 Berlin-Köpenick

- Inspection from June 2023 to June 2023
The current status of the mains connection will be checked and documented. - Civil engineering & grid cable laying from August 2023 to October 2023
Cable trenches will be created, power cables laid and cable distribution cabinets installed. The surface of the ground will be restored (if necessary temporarily). Temporary restrictions will apply. - House connection renovation from August 2023 to November 2023
One of the three variants will apply for you:
A) The mains connections will be reconnected from the overhead line to the new underground cable network.
B) Old grid connections will be replaced with new grid connections.
C) New grid connections will be provided for overhead line connections.
A company commissioned by us will make an appointment with you for installation. Restrictions will apply at certain times. - Shutdown of overhead line network approx. April 2024
End of supply via overhead line. - Dismantling of overhead line network from April 2024 to May 2024
Dismantling of overhead line and masts. Different measures may apply if public lighting is present on the overhead line/masts.
Questions and answers
Would you like to know why we are replacing the power lines and mains connections? You can find answers to your questions here:
Why are overhead lines being converted to an underground power grid?
In order to offer you better security of supply, we will be modernising our distribution network by laying low-voltage cables. Once the renovation is complete, your grid connection will meet the requirements of modern power consumption.
How will this be achieved?
The first step will be to arrange an inspection and determine the current supply situations.
The cables will then be laid in the paths or roads.
As soon as the cable laying is complete, the mains connections will be renovated.
After the renovation, the old grid connections will be dismantled if necessary.
Approximately three months after the final grid connection has been renovated, the overhead line network will be shut down.
In the final step, the overhead line network will be dismantled (different measures may be implemented for public/private street lighting).
I already have a cable connection, how will this be renovated?
For plastic connections, the cable will be reconnected from the overhead line to the cable laid in the ground. For metal connections, the building connection part will be replaced with a new building connection column. In both cases, the property will be without power during installation (approx. 1-2 h).
What is an overhead line connection?
An overhead line connection can be a building connection mast on the property, roof stands on the house or a gable connection on the house or arbour.

When do I need an electrical installation company?
For overhead line connections. You can find an electrical installation company in your area listed in the Stromnetz Berlin GmbH installer directory at: https://www.stromnetz.berlin/anschließen/installateure/
Why do I have to pay the costs for an overhead line connection for the connection from the main connection column to the electricity meter myself?
According to the German Grid Connection Ordinance (NAV) § 13 para. 1, the connectee is liable to the grid operator for the proper installation, extension, modification and maintenance of the electrical system beyond the house connection fuse (system).
Where can I find a registered electrical installation company?
You can find an electrical installation company in your area listed in the Stromnetz Berlin GmbH installer directory at: https://www.stromnetz.berlin/anschließen/installateure/
When will my connection be renovated?
We have published all current renovation projects at the top of this page. Please check the overview to see if your area is listed. The estimated timetable can be found in the project overview.
When will the overhead line be switched off?
We have published all current renovation projects at the top of this page. Please check the overview to see if your area is listed. The estimated timetable can be found in the project overview.
Will my electrical connected load on the house connection change?
The connected load will remain unchanged.
What is my electrical connected load on the house connection?
The connected load is generally 14.5 kVA (corresponds to 14,500 watts) for residential areas or detached houses and 8 kVA (corresponds to 8,000 watts) for allotments. (possibly different for electric hot water preparation, heat pump, charging infrastructure, etc.)
Can I get a higher electrical connected load as part of the renovation?
A separate service request (in writing) is required for this. A new grid connection contract will be required, which the landowner must agree to.
Am I the connectee as a lessee or tenant of a plot or an entire site?
Yes.
Why is a contact telephone number requested in the grid connection contract?
We require a contact telephone number from you in order to arrange an installation date between you and our company carrying out the work.
I am also supplied by my neighbour’s power connection. / I supply my neighbours from my electricity connection. How will the connection be renovated in this case?
A new cable network connection will be placed on the property directly next to the previous customer-owned cable distribution box. The new mains connection will be reconnected to the distributor. The co-supply remains intact.
The co-supplied property does not receive its own free grid connection.
These land users can request an individual and discounted offer for their own grid connection during the renovation measure.

Kontakt
Das Team Freileitungsablösung erreichen Sie unter: freileitungsabloesung@stromnetz-berlin.de
Bitte nur für Anfragen zur Freileitungsablösung in der Niederspannung bis 0,4 kV nutzen.
